Align with the Vendor Project Manager Before You Award

When the owner doesn't carry in-house crews, the responsibility for directing the work in the field lands on the vendor project manager. That person has more direct control over executing the deliverable than anyone on the owner's side. Get that alignment wrong and the owner's project manager spends the job managing the relationship instead of the work. Invoices don't match the work that has been completed, as-builts aren't completed in a timely manner, and issues surface after they've already cost time.

It's a skill on top of project management itself, and it is best when written into the contract. Interfacing with another project manager from another company, with a different reporting structure and another set of priorities, to run your project the way you need it run is common in managing construction projects. It rarely shows up in training or job descriptions.

We've managed enough projects with this structure to know it isn't a soft skill. We've gone as far as writing expectations for the vendor's project manager and their team directly into our contracts.

Why Does Managing a Vendor's Project Manager Require a Different Skill Set?

Some companies only have engineering in-house. Some hire consultants to define the scope before anyone designs. Some carry field crews. The makeup of the internal team versus contracted out dictates how a project is managed.

On many of the projects we manage (defining the problem, developing the project documents, engineering, or getting the work built), the owner hires vendors to fill in the gaps of their team.

A general contractor building custom homes may keep rough carpentry internal and hire out the electrician, plumber, concrete crew, finish carpentry, and landscaper. A commercial builder may run the job with a smaller internal staff and stitch together a dozen subcontracted trades, each with their own project manager. A municipality may run watermain and sewer replacement through contractor firms whose crews move project to project across the region. Different industries. Same reality.

Working with a vendor's project manager is where that skill shows up. We don't direct their welders or reassign their operators. They're not our employees. Expectations go through the vendor's project manager, their superintendent, their foreman. Vendors have different clients with different mandates, and the default is often to run the work the way the last job ran. Our role is to convey the owner's expectation from the start so the vendor aligns with how the project should run.

When that alignment is established from the start, the project runs to the owner's expectations. Construction progress matches the schedule. Invoices match the work that has been completed. As-builts get completed in a timely manner. Issues surface before they've already cost time. When it's missing, the owner's project manager spends more time managing the relationship than managing the deliverable. That's time the project can't afford.

How Do You Write Vendor Project Manager Expectations Into the Contract?

Discussing alignment is not enough. The expectation should be documented.

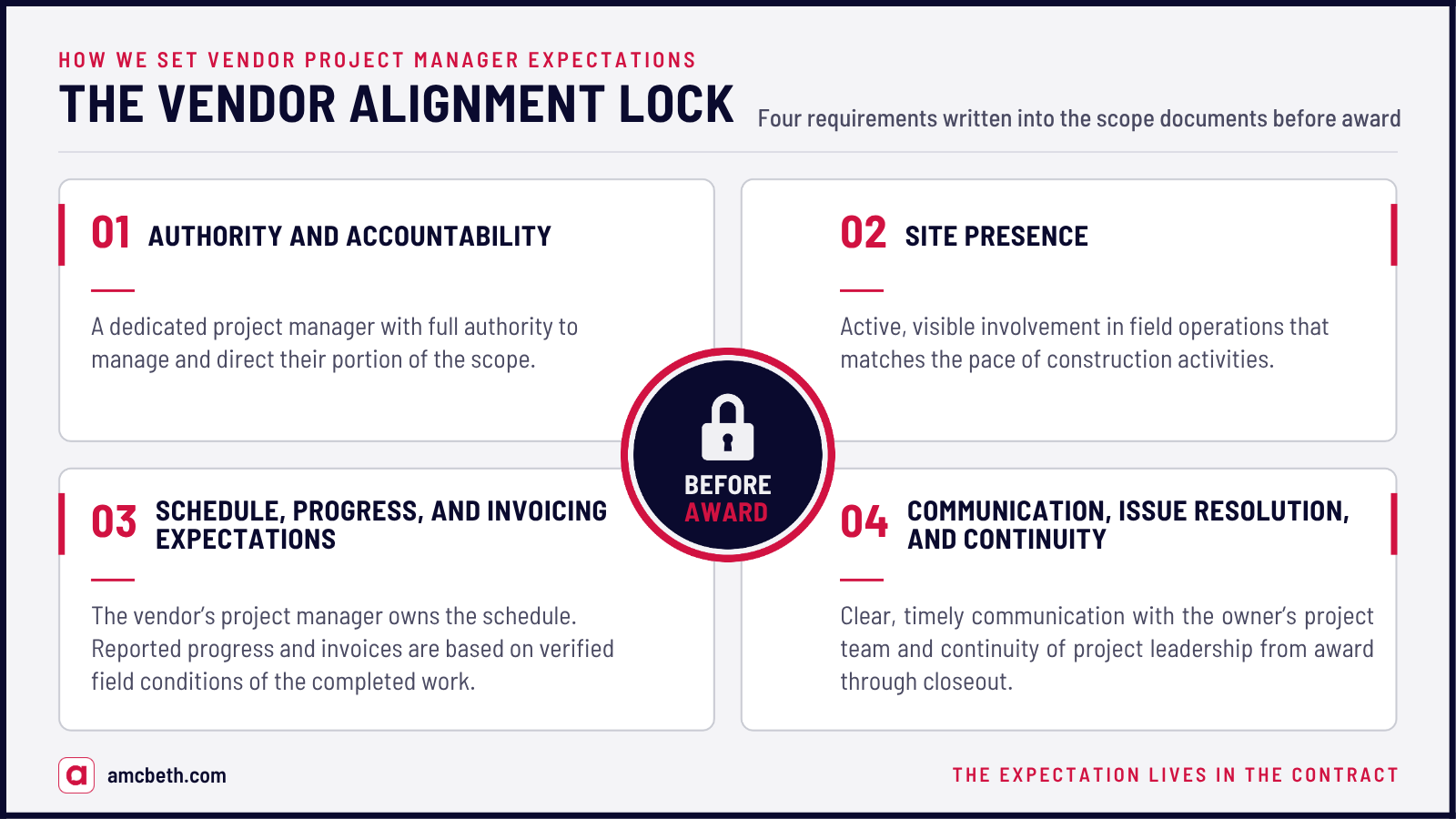

We write the requirements into our scope documents. A vendor then knows before submitting a proposal what is expected of them if they are awarded the work. We call this the Vendor Alignment Lock. It is the discipline of defining what the vendor's project manager must deliver, how they must be present, and what happens when the standard isn't met, before the contract is awarded. The expectation lives in the contract, not the conversation.

The first requirement is Authority and Accountability. The vendor assigns a dedicated project manager with full authority to manage and direct their portion of the scope. Not a coordinator. Not someone who has to call the home office for every decision. A project manager empowered to make timely calls on means, methods, sequencing, and resource allocation. Primary point of contact. They carry the weight that comes with it.

The second requirement is Site Presence. The vendor's project manager maintains active, visible involvement in field operations, not from a desk somewhere else. During active construction, on-site presence is expected no less than one to two days per week, with more during critical activities. If pace or complexity demands it, we can require more.

The third requirement is Schedule, Progress, and Invoicing expectations. The vendor's project manager owns the schedule and keeps working knowledge of the planned sequencing and upcoming activities. Reported progress and submitted invoices are based on verified field conditions of the completed work. They engage regularly with their team to confirm actual progress, check installed quantities and crew pace against the plan, and make the owner aware of risks early.

The fourth requirement is Communication, Issue Resolution, and Continuity. Clear, timely communication with the owner's project team via the appropriate communication method is paramount. This includes escalation of risks and emerging conditions. Issues should be identified and managed before they grow into schedule, cost, or operational impacts.

If the assigned project manager becomes unavailable or fails these expectations, the vendor provides a qualified replacement with equivalent authority and project knowledge that can meet the owner's expectations. That replacement clause is how the owner stays protected when the vendor's project manager changes mid-project. Without it, the person who sat in the pre-construction meeting and built the working relationship can leave mid-project, and the next person starts from zero. Putting that in the contract doesn't stop turnover. It reduces the chance that a personnel change costs the owner time.

Requirement What It Sets What Happens Without It
Authority and Accountability A dedicated project manager with full authority to manage and direct their portion of the scope. Not a coordinator who has to call the home office for every decision. Decisions stall because the vendor's point of contact doesn't have standing to make them.
Site Presence Active, visible involvement in field operations during active construction. No less than one to two days per week, with more during critical activities. Progress reporting runs on assumptions, not what is actually happening in the field.
Schedule, Progress, and Invoicing expectations The vendor's project manager owns the schedule. Reported progress and invoices are based on verified field conditions of the completed work. Invoices don't match the work that has been completed. Schedule slippage warning signs go unnoticed. The owner loses visibility into where the project actually stands.
Communication, Issue Resolution, and Continuity Clear, timely communication with the owner's project team via the appropriate method, including escalation of risks and emerging conditions. Issues identified and managed before they grow into schedule, cost, or operational impacts. Issues sit unresolved. Risks reach the owner late.

What Do You Check Before You Award the Vendor?

Before awarding a contract that depends on a vendor's project manager to deliver, apply the Vendor Alignment Lock:

  1. Authority and Accountability. Write it into the scope. The vendor's project manager must be able to decide means, methods, sequencing, and resource allocation without escalating to the home office.
  2. Site Presence. Require it during active construction. Set the minimum and reserve the right to increase it based on complexity, phase, or performance.
  3. Schedule, Progress, and Invoicing expectations. Tie progress reporting and invoicing to verified field conditions of the completed work. The vendor's project manager owns the schedule, and reported progress must reflect completed work, not planned work.
  4. Communication, Issue Resolution, and Continuity. Require clear communication with the owner's project team, and include a replacement provision so a mid-project personnel change doesn't cost the owner time.

We spent enough years learning this the hard way. Too many hours on alignment that could have been written into the contract from the start. Eventually we stopped hoping for it and started requiring it. The requirements in our scope documents aren't bureaucratic language. They're how we stop spending project management hours on something that should have been settled before mobilization.

Think First. Execute Strong.

Why does the vendor project manager matter so much when the owner doesn’t carry in-house crews?

When the owner doesn’t carry in-house crews, the responsibility for directing the work in the field lands on the vendor project manager. That person has more direct control over executing the deliverable than anyone on the owner’s side. If alignment is off, the owner’s project manager spends the job managing the relationship instead of the work.

What is the Vendor Alignment Lock?

The Vendor Alignment Lock is the discipline of defining what the vendor’s project manager must deliver, how they must be present, and what happens when the standard isn’t met, before the contract is awarded. The requirements go into the scope documents so the vendor knows the expectation before submitting a proposal. The expectation lives in the contract, not the conversation.

What happens when vendor project manager alignment is missing?

Invoices don’t match the work that has been completed. As-builts aren’t completed in a timely manner. Issues surface after they’ve already cost time. The owner’s project manager spends more time managing the relationship than managing the deliverable. That is time the project can’t afford.

How do you write vendor project manager expectations into the contract before award?

Write the requirements into the scope before the vendor is awarded. Cover authority and accountability, site presence during active construction, schedule and invoicing based on completed work, and clear communication with the owner’s team. Include a replacement provision so a mid-project personnel change doesn’t cost the owner time.

Why include a replacement clause for the vendor’s project manager?

If the assigned project manager becomes unavailable or fails the expectations, the vendor provides a qualified replacement with equivalent authority and project knowledge that can meet the owner’s expectations. Without that clause, the person who built the working relationship can leave mid-project and the next person starts from zero. Putting it in the contract doesn’t stop turnover. It reduces the chance that a personnel change costs the owner time.
